Cruise Terminal | Cruise Center 8 | Warnemünde

In addition to the cruise terminal located at Berth 7, a second cruise ship check-in terminal was constructed in Warnemünde. There are occasions when three ships may call at the same time.

INROS LACKNER SE was contracted for the structural design of the new building. The framework program RSTAB was used for the calculation of the 3D model.

Structure

The new terminal is a four-sided, transparent filigree structure which includes passport, customs, and ticketing facilities. On the land side, solid box structures for building services and restroom facilities were constructed.

The primary supporting structure includes V-shaped tubular steel columns supporting I-beam truss girders. Due to poor soil conditions in the port area, the columns are further supported on piles.

In addition to the check-in hall, there is a large service building for baggage handling as well as customs, police, and port personnel. The glazed terminal building roof provides a narrow covering over the entire terminal building but has no structural connection to it.

With the trapezoidal building shape, the architect has additionally provided a terminal wharf.

Location Am Passagierkai, Liegeplatz 8
18119 Rostock, Germany
Investor
Architect
Structural Analysis


Project Specifications

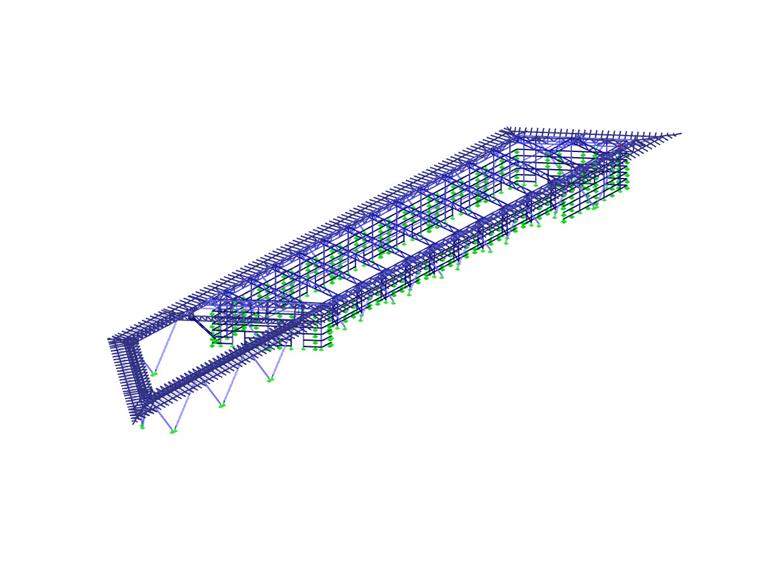

Model Data

Number of Nodes 2943
Number of Members 5065
Number of Load Cases 10
Number of Load Combinations 16
Number of Result Combinations 1
Total Weight 440.105 t
Dimensions (Metric) 183.468 x 31.250 x 12.755 m
Dimensions (Imperial) 601.93 x 102.53 x 41.85 feet

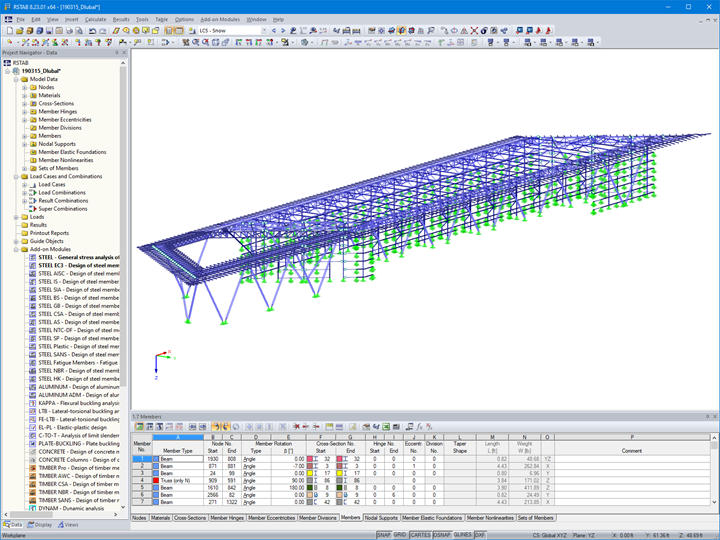

Program Version 8.23.01
